Phase 1 - 2026 Construction Work
The first phase of the construction project is scheduled to begin in July 2026 and is expected to take four months to complete. This will require a full road closure to complete the work; and the disturbed road will be restored to base asphalt. Final surface asphalt will be placed in the summer of 2028.

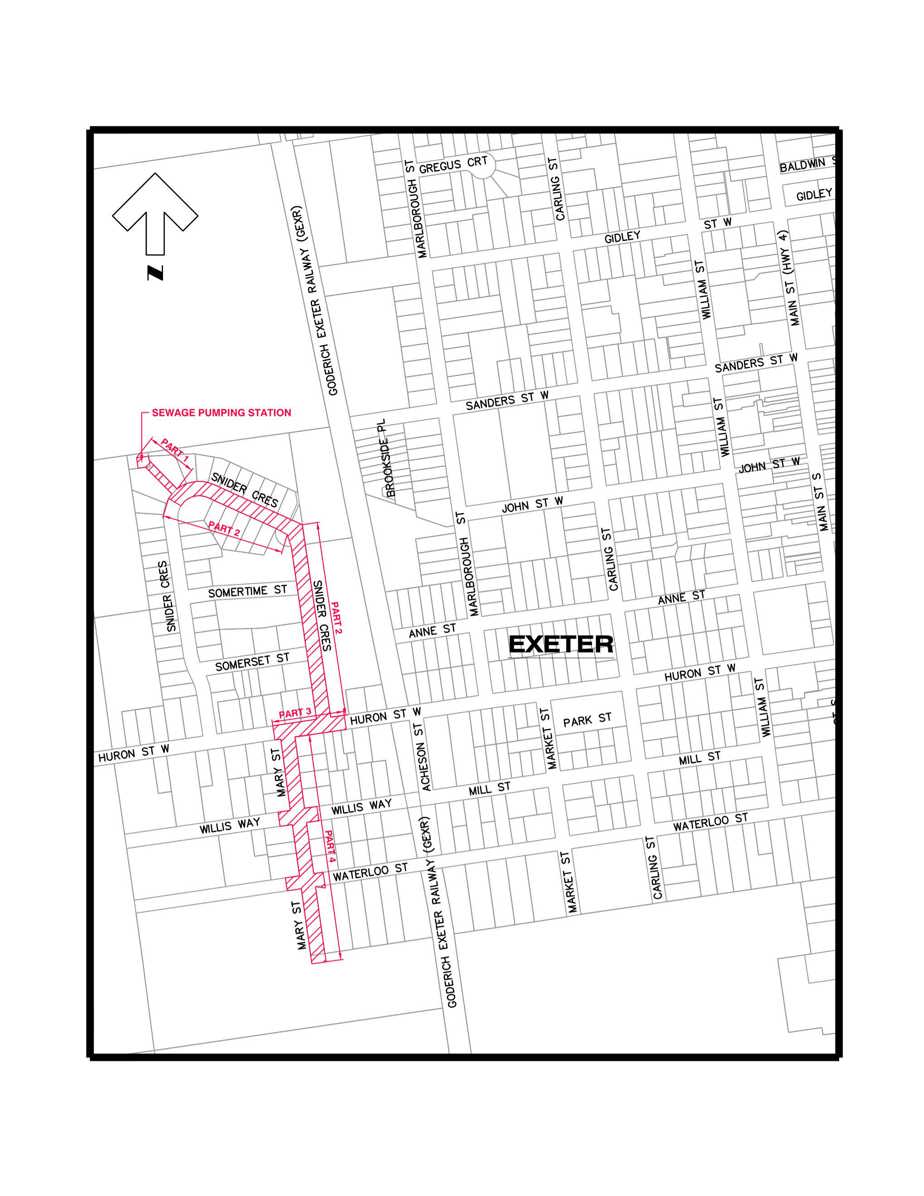

Part 1 - Snider Sewage Pumping Station Site (31 Snider Crescent)
- Replacing the existing sanitary sewer with a larger trunk sanitary sewer
- Modifications to the sewage pumping station inlet works
- Replacing / reinstallation of a storm sewer that will be impacted by the sanitary sewer installation.
- General site restoration
Part 2 - Snider Crescent (North Leg, 29 to 51 Snider Crescent)
- Installation of a large trunk sanitary sewer
- Installation of a smaller local sanitary sewer including reconnection of existing services
- Replacing / reinstallation of some minor storm sewer works affected by the sanitary installations.
- Full width asphalt road replacement (base asphalt only in 2026 with asphalt ramping at curbs)
- Some curb and driveways will need to be replaced where required for the sewer installation.
Part 2 continued - Snider Crescent (East Leg, 51 Snider Crescent to Huron Street)
- Installation of a large trunk sanitary sewer
- Full width asphalt road replacement (base asphalt only in 2026 with asphalt ramping at curbs)
- Some minor curb replacement may be required for the sewer installation.
- Existing local sanitary sewer, sanitary services, watermain and water services remain.
Phase 2 - 2027 Construction Work
The second phase of the construction project is scheduled to begin in April 2027 and is expected to take four months to complete. This will require a full road closure to complete the work; and will involve full road reconstruction and replacement of all underground infrastructure. Final surface asphalt will be placed in the summer of 2028.
Part 3 – Huron Street - 2027 (Mary Street to Snider Crescent east leg)
- Installation of a large trunk sanitary sewer to replace existing local sewer.
- Sanitary services will be reconnected to the new large trunk sewer.
- Reconstruct the roadway including, new sidewalk, curbs, asphalt and roadbase granulars
Part 4 – Mary Street - 2027
- Installation of a large trunk sanitary sewer to replace existing local sewer.
- Sanitary services will be reconnected to the new large trunk sewer.
- Replace the watermain and services on Mary Street
- Replace storm sewer and catch basins
- Reconstruct the roadway including, new sidewalk, curbs, asphalt and roadbase granulars
Phase 3 - 2027/2028 Construction Work
The third phase of the construction project is scheduled to begin in the fall of 2027 and is expected to take six months to complete.
- Twinning of the sanitary forcemain from the Snider Crescent Sewage Pumping Station through existing easements to the Exeter Sewage Lagoons.
